Market & Macro
AI Data Center Delays in 2026: Chip Demand Versus the Power Bottleneck
A 2026 AI data-center review that separates semiconductor demand, project delays, power constraints, and hyperscaler backlog from a blanket AI-demand-collapse claim.

(Sources: S&P Global on data-center development risk, Gartner on power shortages constraining AI data centers, Microsoft FY2025 Q2 earnings call, Alphabet Q4 2025 earnings release, Gartner 2026 semiconductor forecast)
AI data-center delays are now material enough to change semiconductor modeling. They do not prove that AI chip demand is fake. They do make one part of the 2026 setup more fragile: the assumption that every announced campus converts into same-year compute revenue.
Related reading: Fed Rate Outlook in 2026: Data Triggers Before Cuts | Carbon Credit Exposure in 2026: Product Structure and Diligence Questions | U.S. Stock Investing in 2026: Broker Checks Before Stock Selection
The evidence points to a timing problem. S&P Global cited Data Center Watch data showing 20 US projects delayed or canceled in one quarter, while Gartner warned that power shortages could constrain 40% of existing AI data centers by 2027. At the same time, Microsoft still described cloud and AI spend tied to servers, CPUs, GPUs, and contracted backlog.
That combination makes the debate narrower and more useful. The risk is not necessarily a secular demand collapse. The risk is that part of the 2026 chip-demand curve has been pulled forward faster than power, grid access, and physical campuses can arrive.
Thesis
The 2026 AI semiconductor debate should be separated into two questions. The first is whether AI workloads keep growing. The evidence from hyperscaler spending and Gartner's semiconductor forecast still supports that. The second is whether the physical buildout can turn that demand into chip revenue on the market's preferred calendar. That is where the risk is rising.
This article treats the delay evidence as a calendar-conversion risk, not as proof that the AI buildout has failed. That framing matters because it changes the analysis question from "Is AI demand real?" to "How much 2026 revenue assumes power and campuses arrive on schedule?"
Source Evidence Snapshot

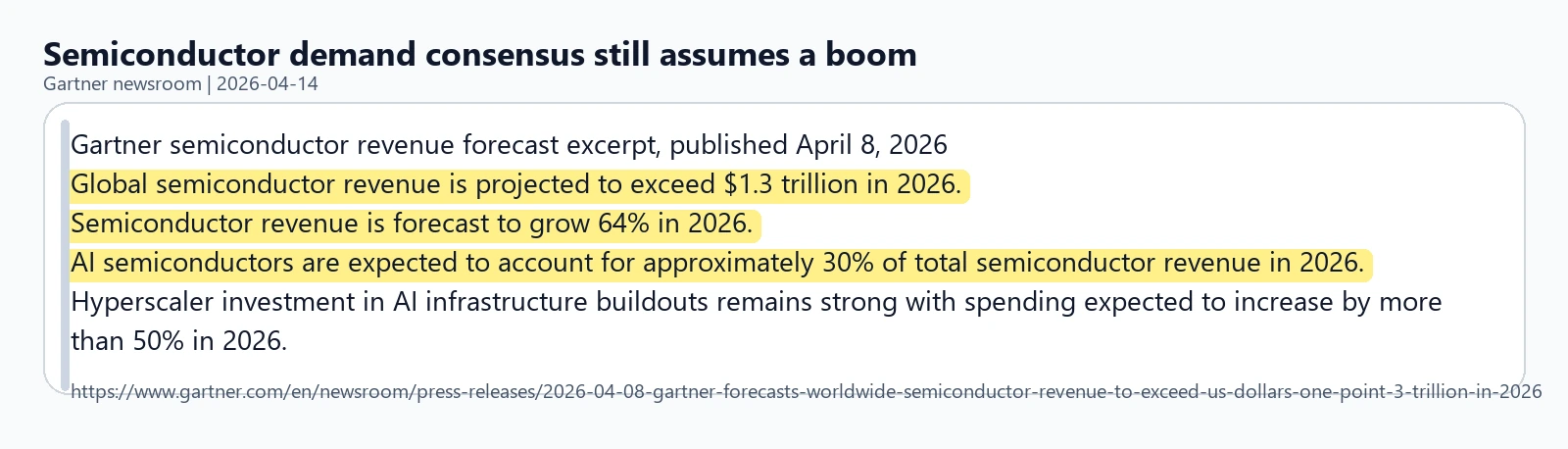

The hero image carries the broad Gartner semiconductor forecast. The body evidence keeps two non-overlapping layers: delayed projects and power constraints. Microsoft remains a linked source note because its capex and backlog material belongs mainly in the individual Microsoft stock article.

Source capture: S&P Global, captured 2026-04-14 from the article on data-center opposition and development risk. The highlighted lines show 20 delayed or canceled projects, about $100 billion in affected investment, and utility power demand rising to 82.3 gigawatts in 2026.
Open source.

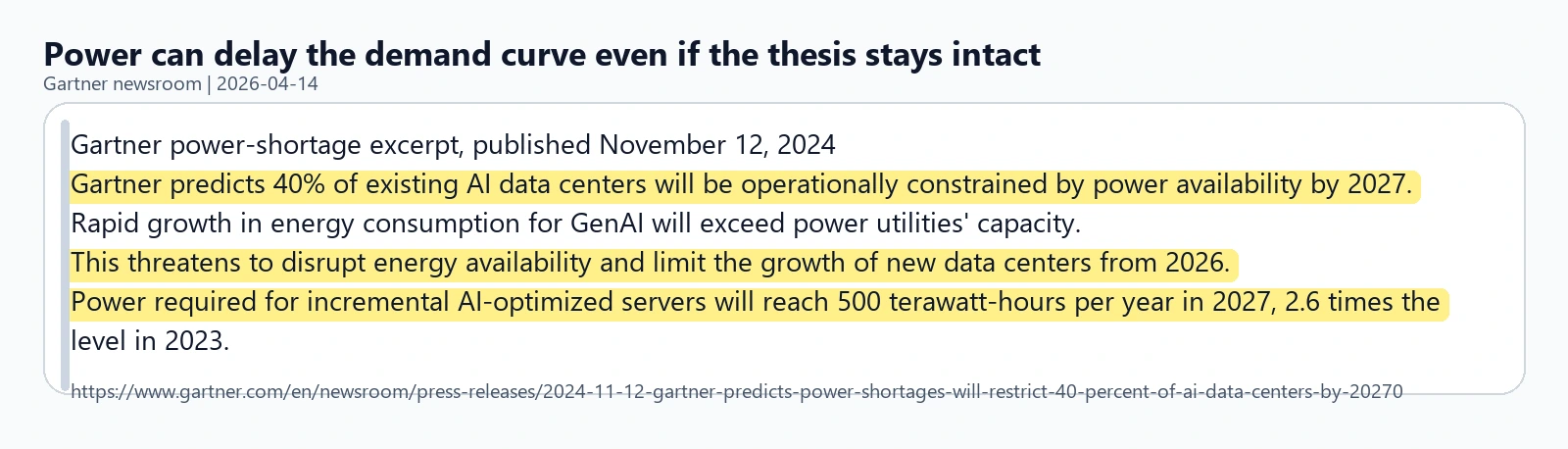

Source capture: Gartner newsroom, captured 2026-04-14 from the press release on AI data-center power shortages. The marked lines show Gartner expecting 40% of existing AI data centers to be constrained by power availability by 2027.
Open source.

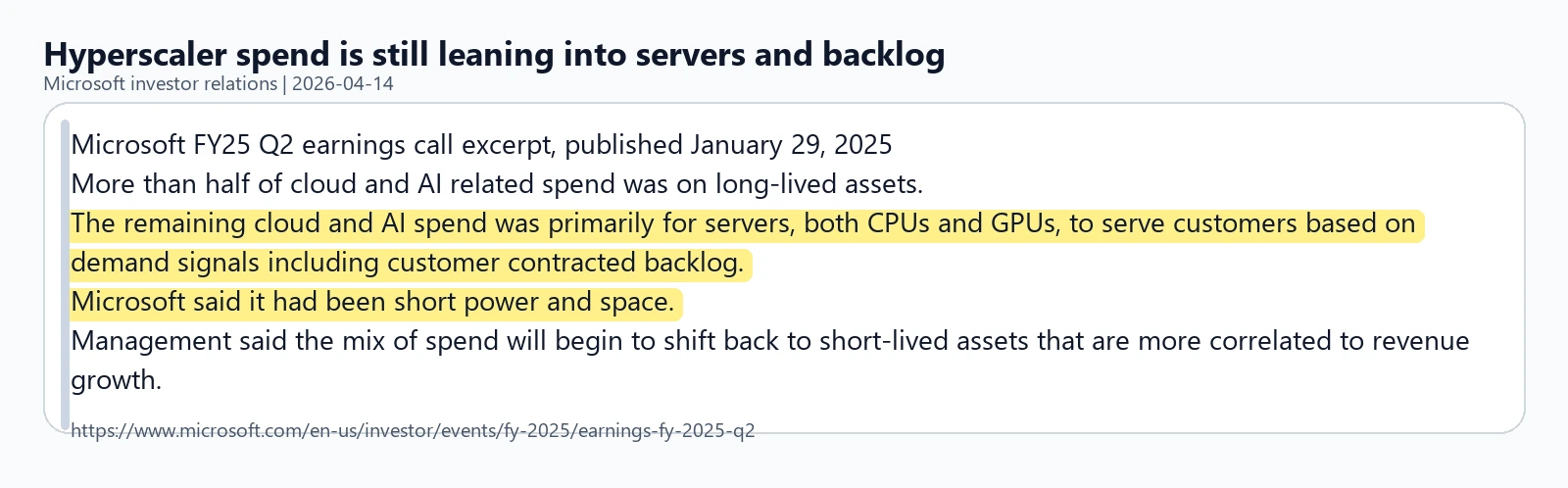

Source note: Microsoft FY2025 Q2 earnings call, captured 2026-04-14. Microsoft remains important context because it tied cloud and AI spend to servers, CPUs, GPUs, contracted backlog, and power/space constraints, but the macro page does not need a third body screenshot from a single company.
What the Street is Pricing
The market's optimistic AI semiconductor case assumes two things at once: demand keeps expanding, and the physical infrastructure arrives fast enough to convert that demand into near-term revenue. The first assumption still has support. The second is becoming more exposed.
S&P Global's cited delay data matters because project timing is not a smooth variable. A campus can remain financed and strategically important while still failing to convert into near-term chip demand if power, permitting, or grid equipment is late.
Gartner's power warning matters for the same reason. If a meaningful share of existing AI data centers can be constrained by power availability by 2027, then new capacity is not just a matter of ordering more chips. It depends on the slower layers of the physical stack.
Microsoft keeps the analysis from becoming too bearish. The company still described cloud and AI spend tied to servers, CPUs, GPUs, and contracted backlog, while also acknowledging shortages in power and space. That is exactly the mixed signal the analysis should expect in a timing-risk cycle: demand can be real while deployment remains uneven.
Risks to the Thesis
The first risk is that the delay evidence gets overused. A delayed data center is not the same thing as canceled AI workload demand. Some chip purchases can shift later rather than disappear.
The second risk is that hyperscaler backlog proves stronger than the delay narrative. If short-lived server spend keeps rising and energized capacity ramps faster than expected, 2026 chip demand may remain more resilient than the bottleneck data implies.
The third risk is model granularity. Semiconductor estimates differ by supplier, product, backlog, customer exposure, and whether revenue is tied to live facilities or speculative future campuses. A broad delay headline can be analytically useful and still be too blunt for company-level conclusions.
What Flips the Call
The timing-risk case strengthens if more greenfield projects slip into 2027, utilities keep reporting longer power-connection queues, or hyperscalers keep spending heavily while more of the spend mix shifts toward buildings, power, and networking instead of immediately revenue-correlated servers.
The case weakens if Microsoft, Alphabet, and peers keep showing server backlog, short-lived compute assets, and actual energized capacity rising fast enough to absorb the buildout. It also weakens if semiconductor companies report demand that is increasingly tied to already powered facilities rather than announced but unresolved campuses.
The clean conclusion is narrower than the headline debate. Data-center delays do not prove that AI chips are a bubble. They do show that part of the 2026 demand curve may be too front-loaded. In a crowded AI infrastructure theme, that timing distinction is large enough to matter.
